Burger Restaurant Financial Model: Drive-Through Burger Restaurant

Plan a drive-through burger restaurant around peak demand, ordering and handover crews, kitchen output, meal costs and startup cash.

  • Excel (.xlsx)
  • Forecast: 60 months · March 2027 opening
  • Lane: One ordering station · one handover window
  • Case: U.S. · USD · Base

Planning several types? Compare 6 burger restaurant formats

Workbook preview, read-onlyr01

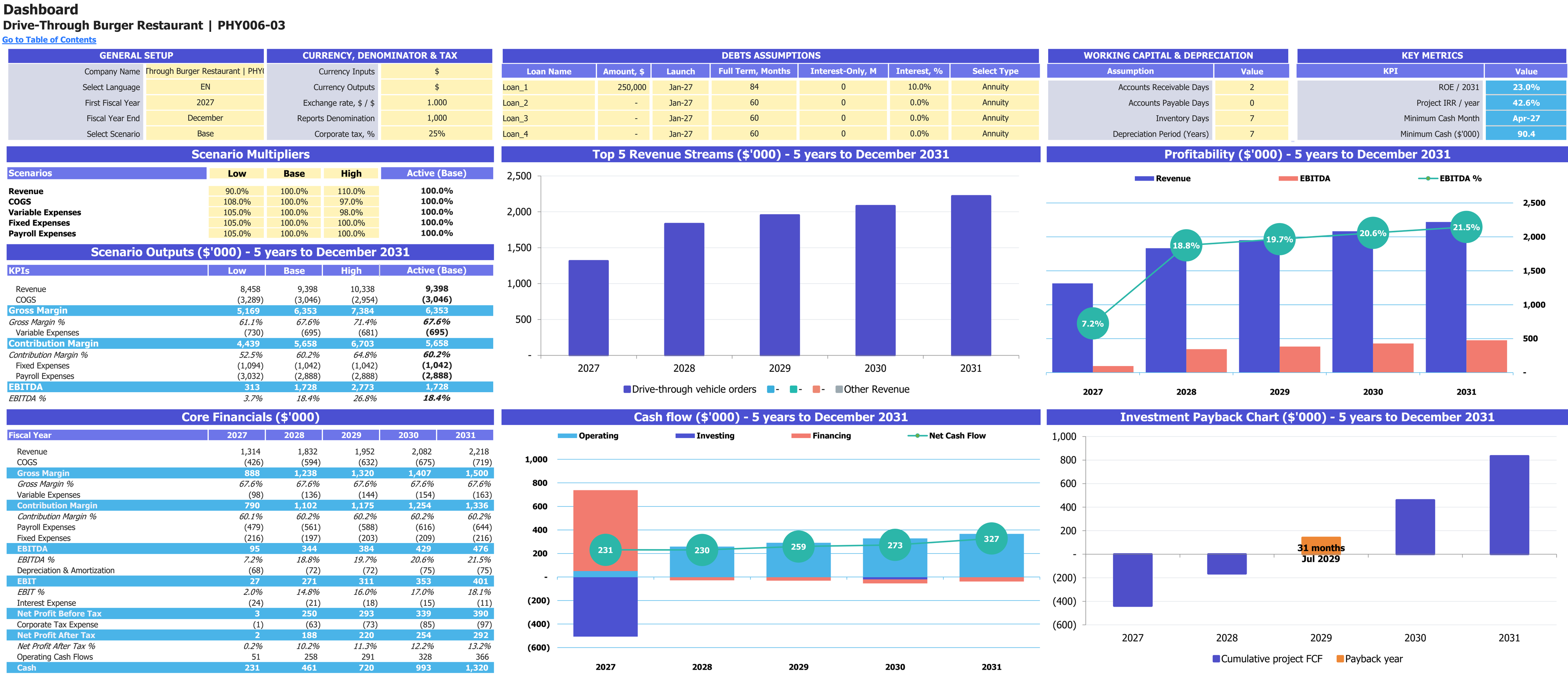

Drive-Through Burger Restaurant workbook: dashboard.
Dashboard

Base-case scenario controls, annual financial results and charts for 2027–2031. Financial report amounts are shown in thousands of USD; percentage measures retain their own units.

Enlarge image in a new tab

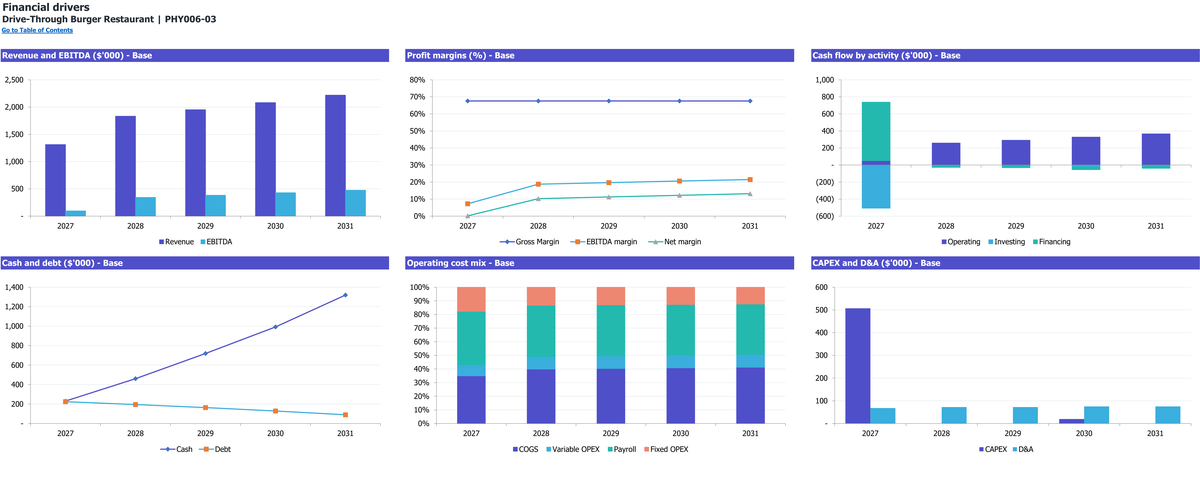

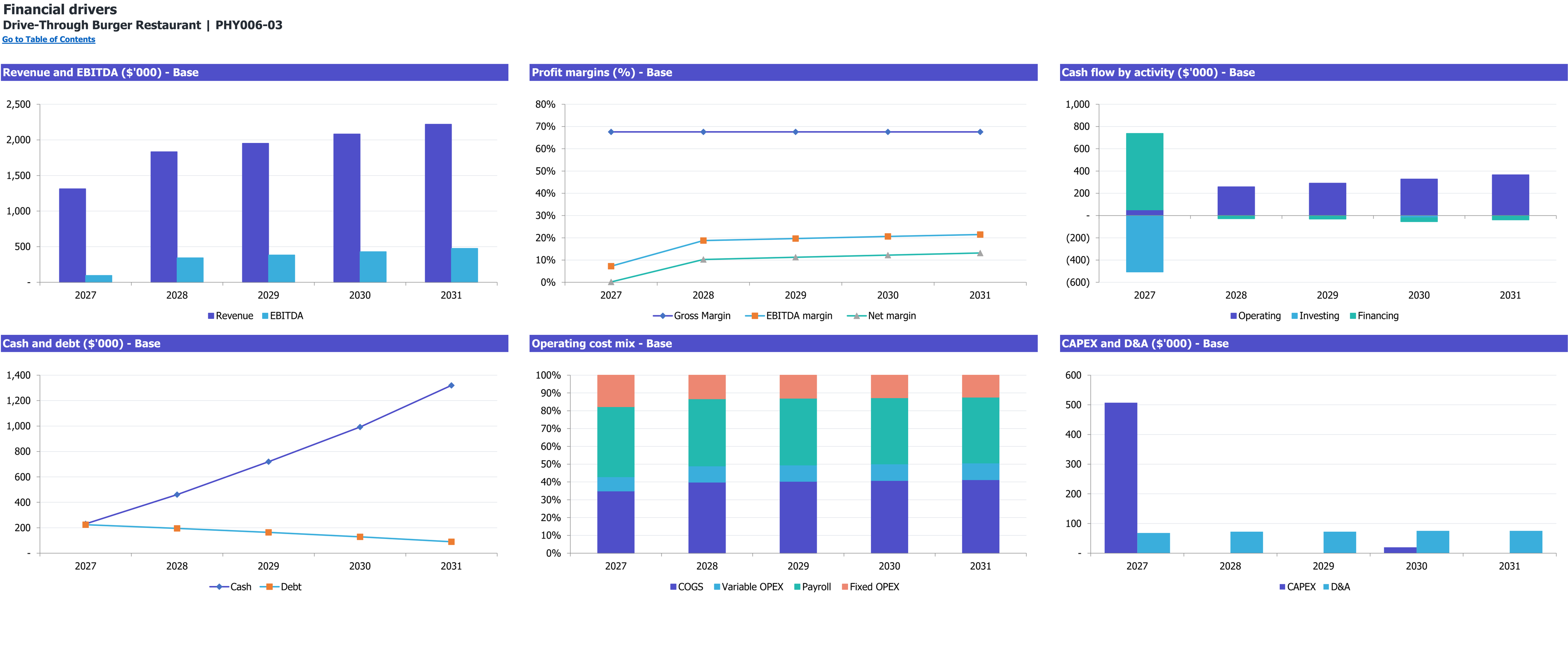

8 selected worksheet views. Figures show this workbook’s starting case.

Workbook overview

What is inside the Excel model

Find the stage that limits completed vehicle orders. This workbook separates peak and off-peak demand, then carries feasible sales through ingredient costs, paid staffing and cash.

Selected worksheets from the documented workbook. Forecast period: January 2027–December 2031. Model reference: PHY006-03.

Inputs you control. Results you can inspect.

On a small screen, scroll within the table to read every column.

Inputs and outputs for the drive-through burger restaurant workbook.
Planning areaInputs you reviewHow they connectResults to inspect
Demand by periodVehicle requests, peak share, peak hours, open days and ramp.Requests are split once between peak and off-peak time.Served and lost orders by period.
Station capacityOrdering and handover cycle times, stations and paid staff.Physical points and productive staffing jointly cap each stage.Practical lane throughput.
Kitchen and order sizeMeals per vehicle, equipment output and productive cooks.Meal production capacity converts into vehicle-order capacity.Feasible completed orders.
Unit costsIngredient basket, yield, packaging, card terms and tender factor.Physical costs derive annual expense ratios for the retained reports.Food, packaging and transaction expense.
Premises and cashBuilding/pad rent, site works, capital, settlement, inventory and funding.Dated costs, debt service and working capital flow through monthly cash.Funding reserve and capital recovery.

Is this the right model for your business?

Check the starting case before changing the assumptions.

The starting operation

  • An independent restaurant with one ordering station and one handover window.
  • An existing 1,000-square-foot building on a 21,875-square-foot pad.
  • A March 2027 opening after refurbishment, with all operating roles paid.

Check the boundary

Greenfield development, a dining room, delivery or a franchise operation needs additional premises, timing and operating assumptions.

Compare the other burger restaurant types

How this business makes money

Connect the unit sold to the resources required by this operating case.

Analysis
A worker handing a food bag to a driver at a compact drive-through, with another car at the ordering speaker.
Ordering, production and handover must each have funded capacity. This scene is conceptual, not a measured site plan.

Revenue logic
Revenue = fulfilled vehicle orders × net order value.

Peak and off-peak requests are constrained separately. Lost peak demand does not move into spare off-peak capacity.

What customers pay for

A vehicle order buys a selected basket of burger meals, sides and drinks.

What limits sales

  • Requests within peak and off-peak service periods.
  • Ordering stations and funded productive order-taking staff.
  • Handover windows and funded productive handover staff.
  • Kitchen equipment, productive cooks and meals per vehicle.

Costs to plan for

  • Ingredients per meal, adjusted for usable yield.
  • Packaging per vehicle and card fees per applicable transaction.
  • Paid owner, preparation, kitchen and lane crews, with payroll load.
  • Building and pad occupancy, utilities, site services and overhead.
  • Fit-out, lane infrastructure, working capital and debt have separate schedules.

Scope and expansion

  • The case assumes an existing, entitled drive-through site.
  • No dining room, delivery, franchise royalties or land purchase is included.
  • Changing lane capacity also requires a supported staffing plan.

Why can unused off-peak capacity coexist with lost sales?

Customers arriving during the peak need service in that period. The model does not shift rejected vehicles into quieter hours. Ordering, kitchen and handover capacity must therefore support the peak mix as well as the daily total.

Unit sold
One completed vehicle order.
Time split
Peak and off-peak demand are constrained separately.
Slowest stage
Ordering, kitchen or handover can bind.

What to establish for your own operation

  1. Time each station separately from total customer waiting time.
  2. Observe peak arrivals and meals per order.
  3. Validate staff coverage and access/stacking constraints at the site.

Follow the plan from demand to cash

Open each section for the assumptions, calculations, and limits of this workbook’s starting case.

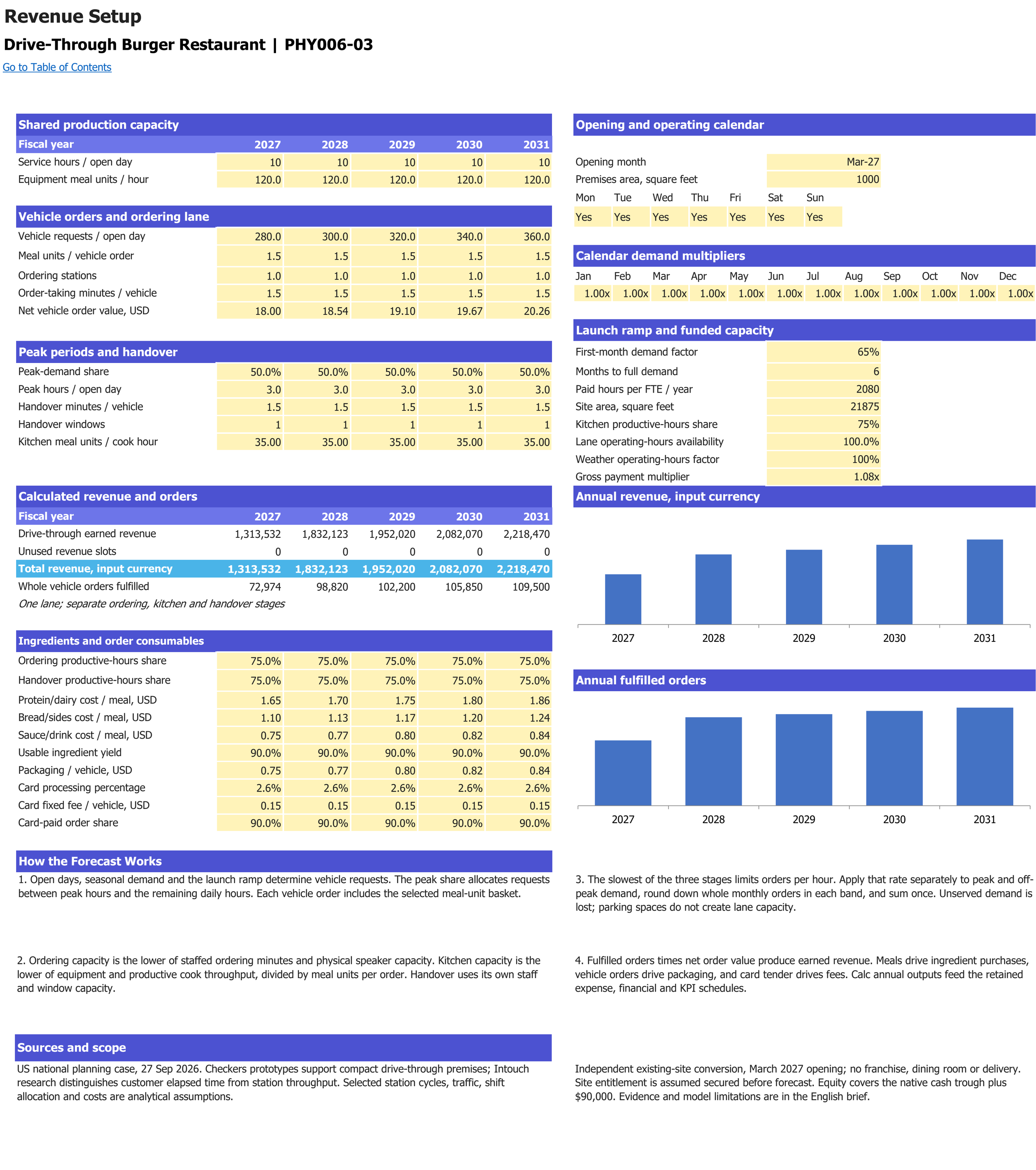

Check the slowest stage during the busy periodRevenue

The starting case requests 280 vehicles per open day, with half arriving in three peak hours. The remaining half arrives in seven off-peak hours. Both ordering and handover use selected 90-second station cycles.

Kitchen equipment and productive cooks constrain meal output. One vehicle buys 1.5 meal equivalents at an initial $18 net ticket. The slowest stage caps each period independently; rejected peak demand is lost.

  • The case operates all seven weekdays with a six-month opening ramp.
  • Station cycles are assumptions, not measured total customer-journey times.
  • Monthly coverage does not simulate minute-by-minute queues or stacking-space spillback.

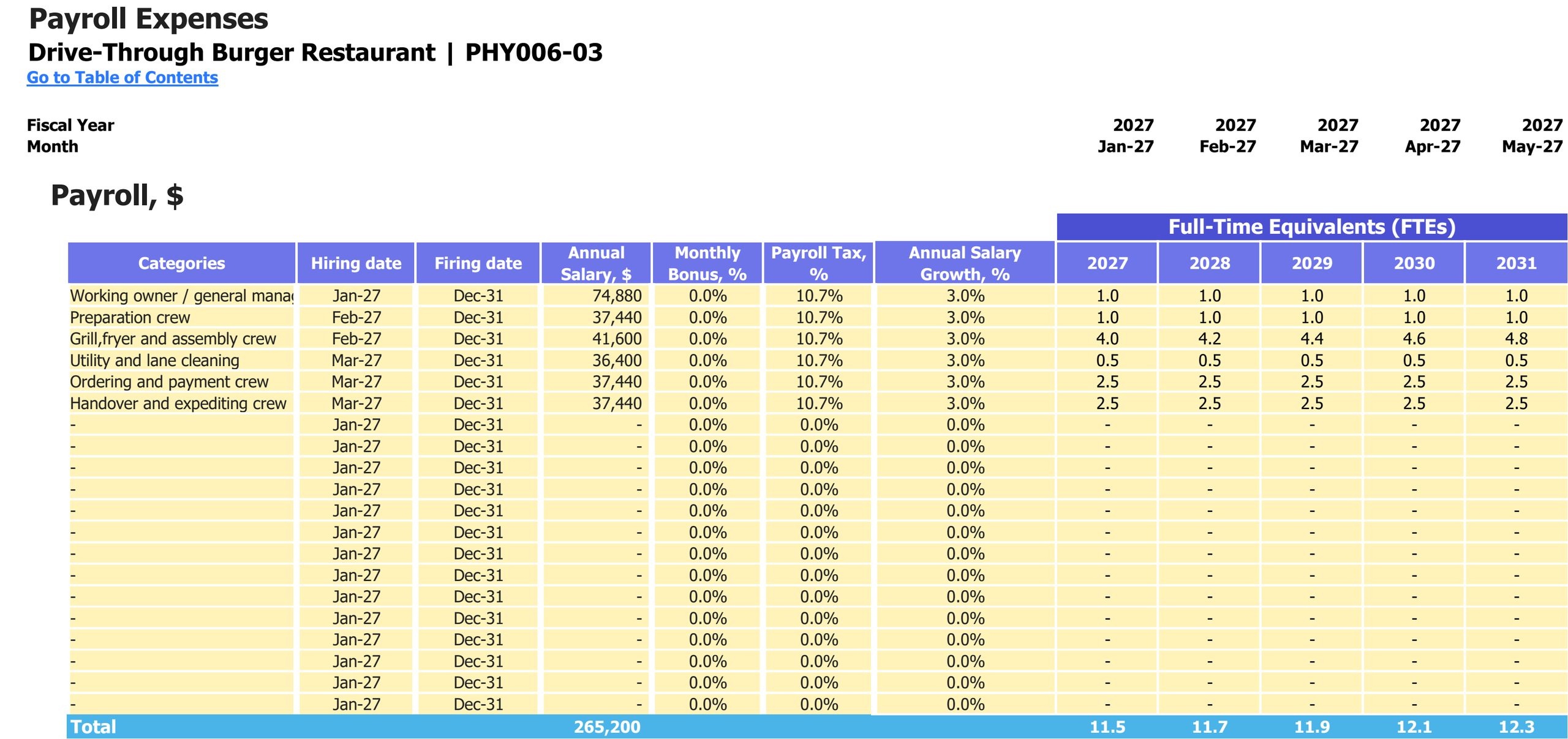

Fund the people behind the lane capacityPayroll

The initial 11.5-FTE team grows to 12.3 FTE. The owner, preparation, utility, ordering, handover and kitchen roles are all paid. Only the designated bottleneck crews create their respective productive capacity.

Ingredients start at $3.50 per meal before a 90% usable yield. Packaging is $0.75 per vehicle. Card expense uses 90% card share, a 2.6% rate, $0.15 per transaction and the selected gross-tender factor.

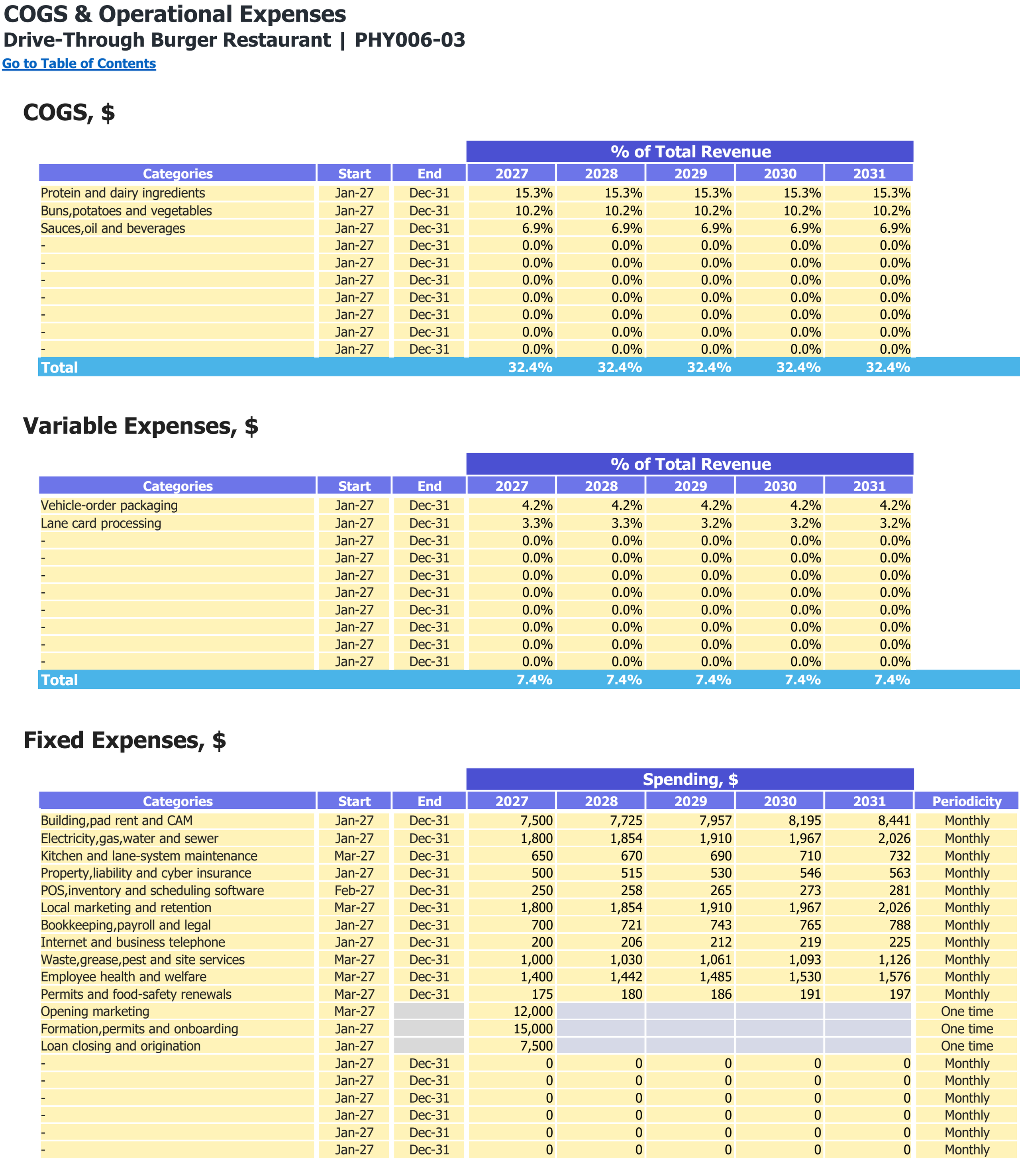

  • Annual expense shares are derived from physical Base costs.
  • Monetary scenarios scale financial budgets independently; they do not rerun physical meals.
  • Payroll load and a separate employee-benefit pool are counted once.
Include the pad and lane in the opening budgetCAPEX

Initial CAPEX is $507,100, including $46,100 spent contingency. A separate $90,000 allowance covers lane pavement, drainage and canopy; the compact building does not remove these site costs. January 2030 adds $20,000 replacement capital.

January funding is $713,000: $463,000 equity and $250,000 debt. The loan assumes 10% fixed interest and 84 monthly annuity payments. Funded minimum cash is $90,390 in April 2027.

  • The property is assumed secured and entitled before the forecast.
  • Receivables use two sales days; food inventory uses seven COGS days; payable days are zero.
  • The retained reserve is cash, separate from spent capital contingency.

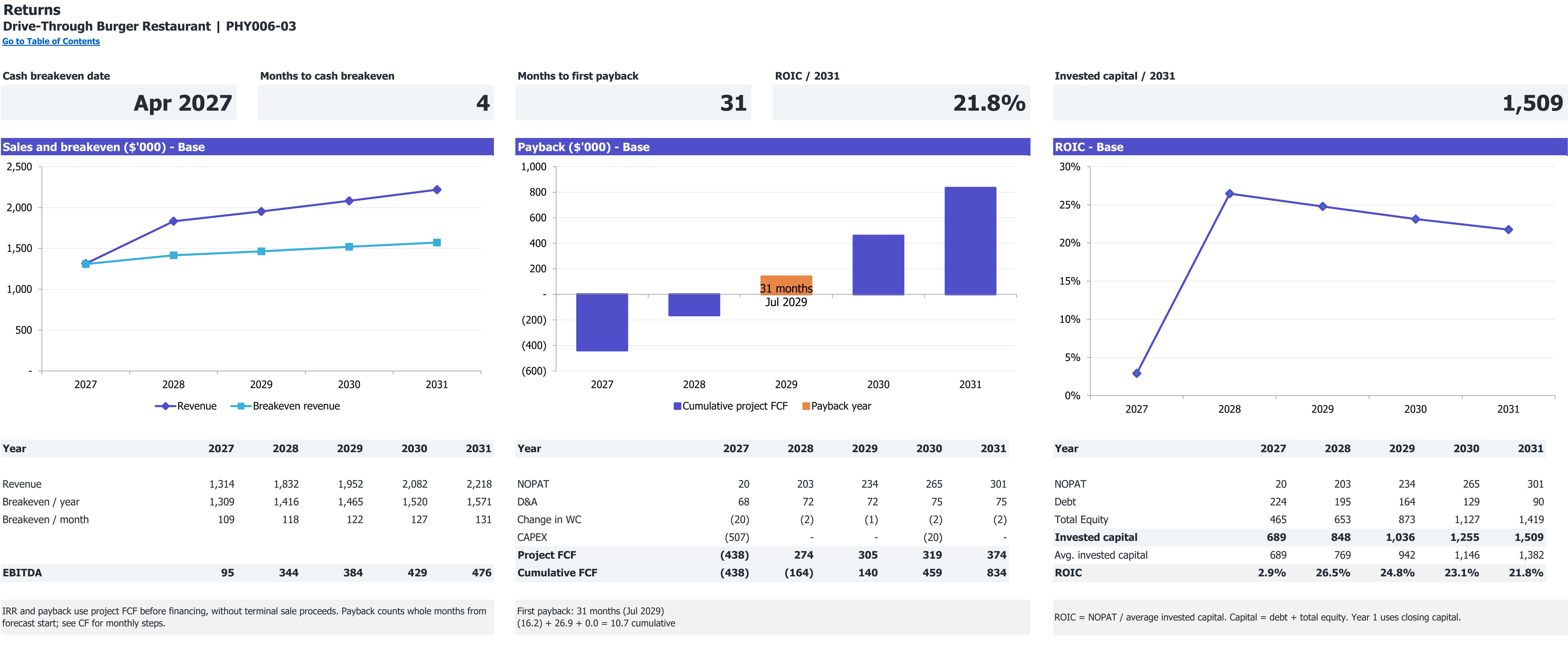

Compare operating coverage with project recoveryCF

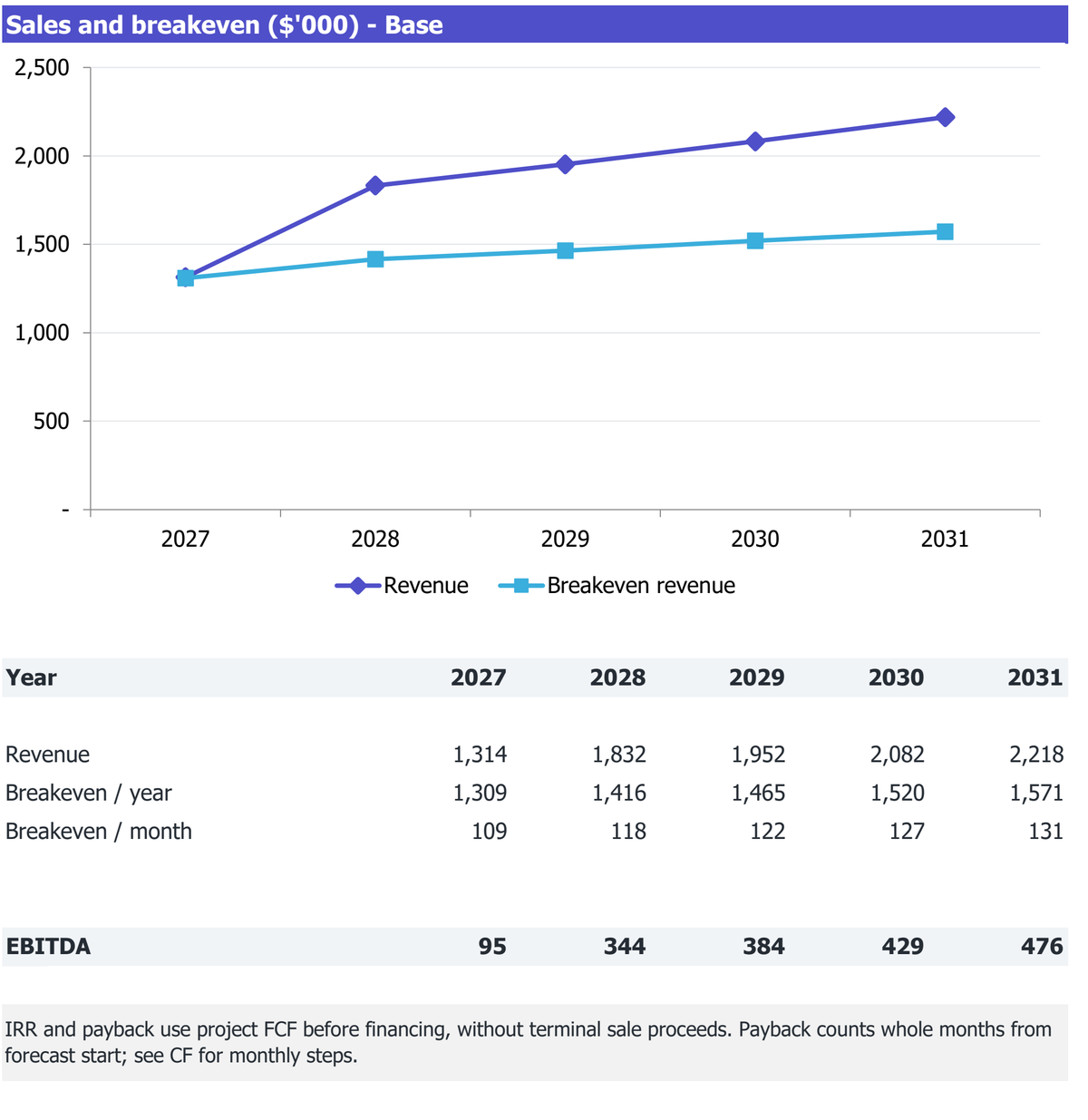

Base 2027 revenue is $1,313,532 and EBITDA is $95,169 across ten service months and two pre-opening months. EBITDA and operating cash first become nonnegative in April 2027; EBIT follows in May, with all three remaining nonnegative thereafter.

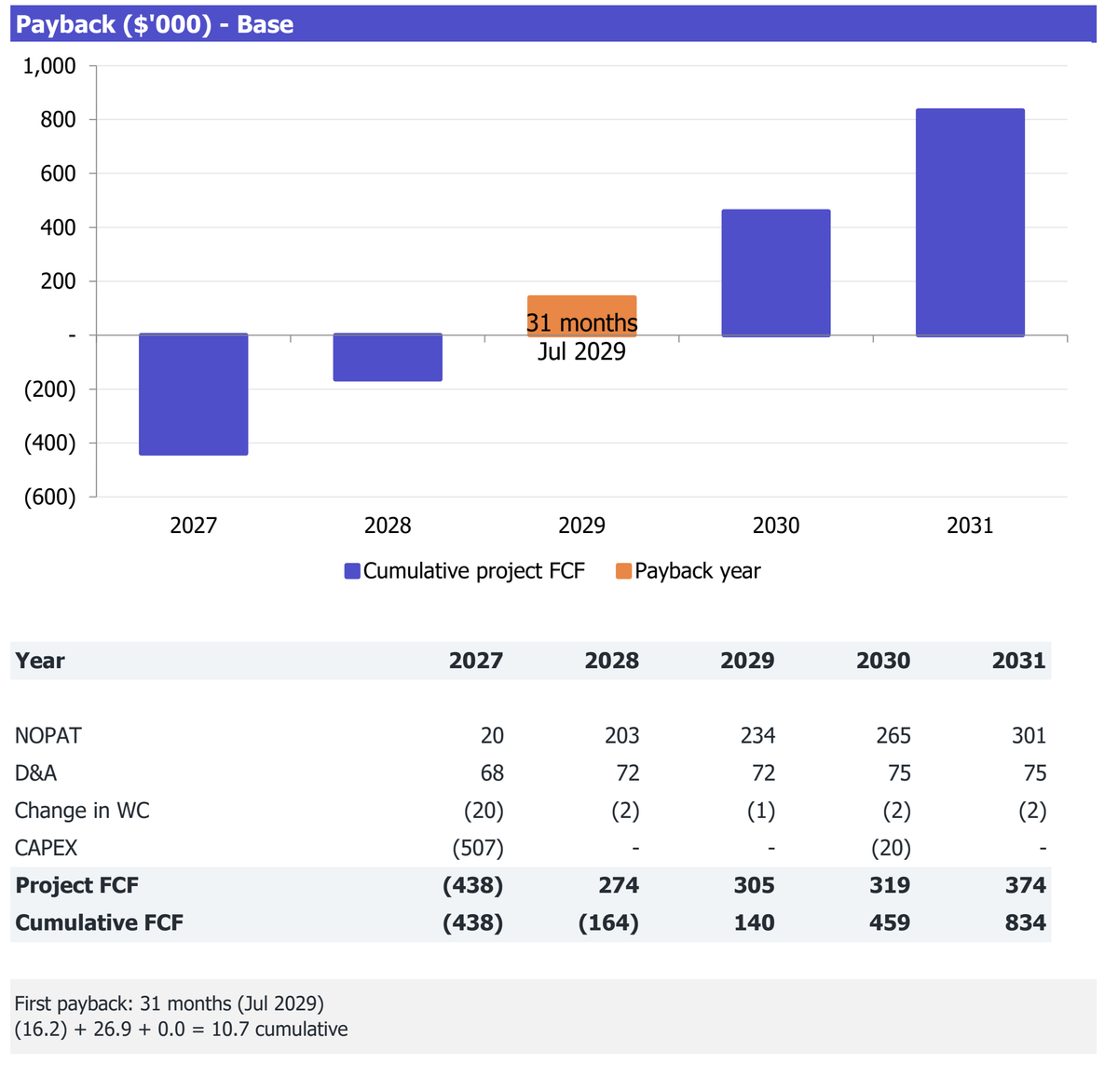

Project payback is July 2029, month 31 from January 2027. It uses cumulative undiscounted unlevered cash, including project deficits and replacement investment, with no exit sale or owner distributions.

  • Money-only Low and High cases are separate from physical lane tests.
  • Daily capacity can look adequate while the peak period still loses orders.
  • The forecast depends on local traffic, prices and productive staffing.

Selected results from the starting case

Modeled results in USD unless stated otherwise. These describe the selected inputs, not an estimate for your location or a guaranteed outcome.

Modeled case
First-year revenue
$1,313,532Base · USD · calendar 2027, including ten service months.
First-year EBITDA
$95,169Base · USD · calendar 2027, including pre-opening expenses.
Initial CAPEX
$507,100Base · USD · January–February 2027, including site works and spent contingency.
Minimum funded cash
$90,390Base · USD · April 2027 after the selected equity and debt.
Project payback
July 2029Base · month 31 from January 2027; undiscounted unlevered project cash, excluding financing and exit.

Make the case your own

Work from the operating plan toward the cash requirement.

  1. Set demand, peak concentration, open hours and the launch ramp.

  2. Review station cycles, kitchen output and funded crews together.

  3. Replace meal, packaging, premises and installed-site budgets.

  4. Inspect monthly cash and resize fixed funding before interpreting payback.

Interpretation and scope
  • This U.S. planning case assumes an existing entitled site, not a greenfield permitting schedule.
  • Cycle times, demand and staff productivity require local validation.
  • The model does not simulate minute-by-minute queues, spillback or detailed rosters.
  • Monetary scenarios do not recalculate physical meal economics; zero revenue with positive fulfilled orders is invalid.
  • No land purchase, delivery, franchise royalty, tax-loss carryforward, owner distribution or terminal sale is included.

The workbook is an Excel file for local planning. Learn how to interpret assumptions and evidence.

Each operating type calls for its own financial structure.

Compare all 6

Questions

Does a five-minute customer journey imply twelve vehicles per hour?

No. Elapsed journey time differs from the cycle of a station that overlaps with other work. The model uses separate ordering, kitchen and handover limits.

Can off-peak capacity serve rejected peak orders?

No. Rejected peak demand is lost in this case.

Is food cost simply a chosen percentage of sales?

The Base percentage is derived from meals, ingredient purchase budgets and usable yield. The retained reports receive annual shares; money scenarios operate separately.

Does the small building remove site investment?

No. The budget separately includes lane pavement, drainage, canopy and other access infrastructure.

Does project payback measure owner distributions?

No. It measures unlevered project recovery; no shareholder distributions are scheduled.

What if a purchased file is damaged or cannot be downloaded?

See the refund and replacement policy for file correction, replacement and download assistance. Keep the product name and your order reference when requesting help.

Which software does the workbook use?

The documented file is an Excel workbook (.xlsx). Compatibility with other spreadsheet applications is not established by the file extension.

Evidence and scope

Operationally specified by the analyst. An active local operator, commercial demand and legal permission require separate validation.

The links below provide operating-format context; they do not verify the workbook’s selected inputs or calculated returns.

The workbook guide and figures describe model PHY006-03, revision r01, for January 2027–December 2031. These are a documented planning case, not observed results for a particular business.

Read our methodology and how to read financial assumptions.
